Nirmitee.io
Asset ManagementHealthcare

How to Implement RFID Asset Tracking in a Large Hospital

May 29, 202613 min readUpdated Oct 19, 2026
Written by
Gulshan Prajapati
Gulshan Prajapati

Software Development Expert

Writes about software development, scalable architecture, and practical problem-solving across modern digital products. Focuses on turning complex technical ideas into clear, real-world solutions.

How to Implement RFID Asset Tracking in a Large Hospital

Quick answer: Hospital RFID asset tracking is deployed in four phases over 16 weeks: clean the asset register and order hardware (weeks 1-4), pilot 100 assets in two low-risk departments (weeks 5-8), roll out department by department from central stores to general wards (weeks 9-12), and finish with emergency, OT, and ICU (weeks 13-16). ICU and OT go last, never first. A 500-bed hospital with about 3,000 assets budgets ₹21-22 lakh ($26,000) for year-1 hybrid barcode + UHF RFID hardware and 320-480 internal staff-hours.

Implementing RFID asset tracking in a large hospital is not a software project. It is a 16-week operational change touching every department. The temptation is to deploy fast, hospital-wide, in a single sprint. The result is usually a disruption to clinical operations and rejection by ward staff.

This guide walks through a phased deployment plan refined across large hospital deployments in India. It is written for the biomedical lead, IT director, and operations head who will own the rollout. The principle: low-risk departments first, ICU and OT last, never simultaneously.

Reviewed by the Assetly product team at Nirmitee.io. Last updated August 2026.

What RFID Asset Tracking In A Hospital Actually Covers

RFID asset tracking in hospitals means fixing a passive UHF tag (or, for some assets, HF or BLE) to each piece of equipment and reading those tags automatically at doorways, on carts, and with handhelds, so the asset register updates itself instead of waiting for someone to scan a barcode. The equipment that gets tagged in a typical large hospital:

  • Mobile biomedical equipment: infusion pumps, syringe drivers, portable monitors, suction units, wheelchairs, stretchers.
  • High-value fixed equipment: ventilators, anaesthesia workstations, dialysis machines, imaging consoles (tagged for audit and AMC, not location).
  • OT and CSSD: instrument trays and sets with autoclavable tags.
  • Linen and consumables: laundry-grade tags on sheets and gowns, passive tags at store exits for pilferage control.
  • IT assets: laptops, tablets, COWs (computers on wheels).

Whether RFID is the right layer for each asset class, or barcode is enough, is covered in our RFID vs barcode comparison. This guide assumes the decision is made and the hospital is above the roughly 2,000-asset threshold where RFID earns its cost.

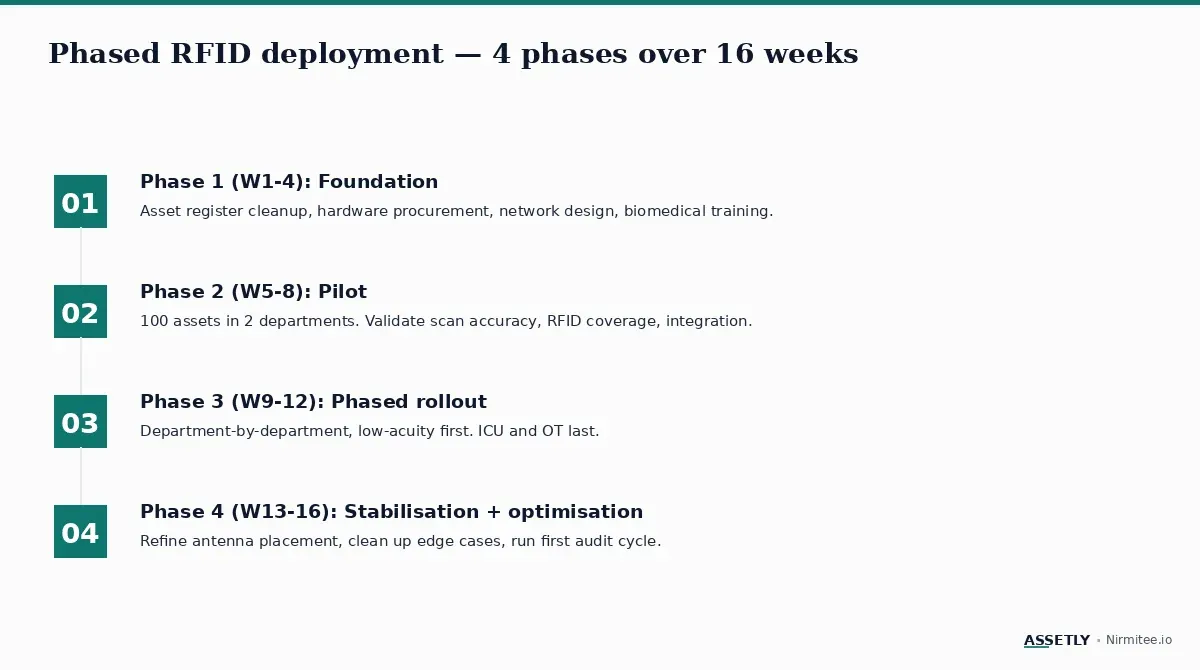

The 16-Week Plan At A Glance

PhaseWeeksWhat HappensExit Criterion
1. Foundation1-4Register cleanup, hardware procurement, network design, biomedical trainingRegister reconciled; hardware ordered; team trained
2. Pilot5-8100 assets in central stores and biomedical workshop98%+ scan accuracy; HIS/ERP integration tested
3. Phased rollout9-12Central stores, workshop, general wards, pharmacy, diagnostics60-70% of asset base live
4. Stabilisation13-16Imaging, emergency, OT, ICU100% live; first audit cycle scheduled

Phase 1: Foundation (Weeks 1-4)

The pre-deployment phase. Four parallel work streams:

  • Asset register cleanup: a physical inventory walk-through. The existing register is reconciled to physical reality before tagging starts. Most hospitals discover 5-12% variance; the cleanup cycle takes 2-3 weeks. Assetly's import pipeline normalises department names and splits duplicate records automatically, which cuts most of the manual work out of this step.

  • Hardware procurement: printers, RFID tags, readers, antennas, network switches. The procurement cycle in India typically takes 4-6 weeks; start ordering in Phase 1 even though installation isn't until later. See the sections on RFID readers and antennas, tag selection, and RFID label printers for model-level guidance.

  • Network design: a dedicated PoE switch for asset tracking, an antenna placement floor plan, and an RF interference survey. Do this before the readers arrive, not after.

  • Biomedical training: the biomedical team must own the system. 8-12 hours of structured training in Phase 1 prevents the most common adoption failures later.

Hardware Checklist For A 500-Bed Hospital

ItemQuantity (≈3,000 assets)Notes
Industrial RFID printer-encoder1-2Zebra ZT411R class; buy RFID-capable even for the barcode share
UHF RFID labels1,500-2,000Mobile and OT assets; on-metal variant for steel-bodied equipment
Polyester barcode labels1,000-1,500Stationary assets stay on barcode
Portal readers + antennas4-8 portalsWard exits, OT corridor, central stores, ED
Handheld RFID readers2-4Audits and spot searches
Dedicated PoE switch1 per floor clusterNever shared with patient monitoring
Middleware/asset platform1Assetly includes reader middleware and HIS/ERP connectors

Phase 2: Pilot (Weeks 5-8)

100 assets across 2 departments. Recommended pilot departments: central stores (low risk, high asset count) and biomedical workshop (high control over the environment). Pilot objectives:

  • Validate RFID scan accuracy (target: 98%+ across all reader-tag combinations).
  • Confirm portal reader and ceiling antenna placement covers the actual asset paths.
  • Test the asset management software integration with HIS / ERP (Assetly ships connectors for SAP, Tally, and Oracle, plus HL7 for the HIS).
  • Establish daily and weekly operational rhythms: who does what, when.

Pilot success criteria are non-negotiable. If scan accuracy is below 98% at the end of the pilot, do not proceed to Phase 3. Fix the pilot environment first.

Phase 3: Phased Rollout (Weeks 9-12)

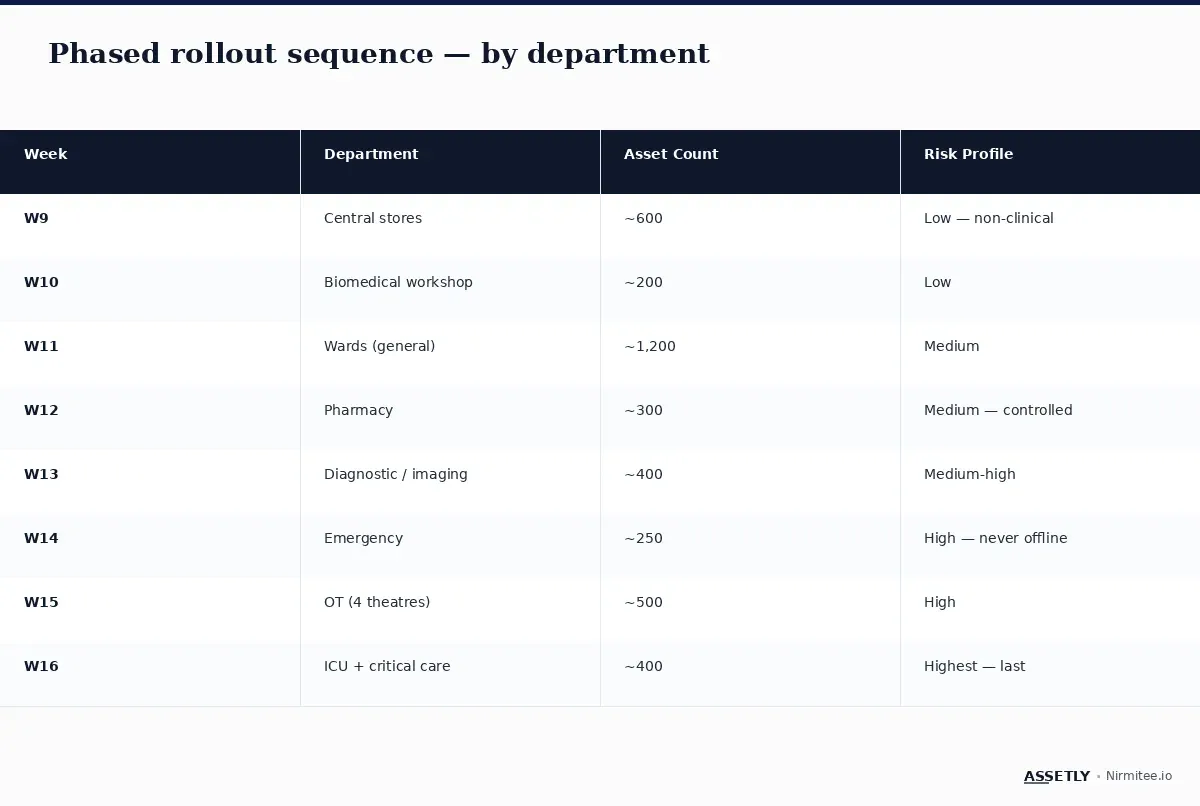

Department by department, low-acuity first. The sequence is critical:

  • Week 9: Central stores (~600 assets, low clinical risk).
  • Week 10: Biomedical workshop (~200 assets, full team control).
  • Week 11: General wards (~1,200 assets, medium risk).
  • Week 12: Pharmacy + diagnostic/imaging (~700 assets combined).

Each department gets 1-2 days of on-site biomedical support during go-live, then daily check-ins for the first week. By the end of Phase 3, roughly 60-70% of the asset base is on the system.

Phase 4: Stabilisation And Optimisation (Weeks 13-16)

The high-risk departments (emergency, OT, and ICU) go last. These departments cannot tolerate deployment disruption. By Phase 4, the deployment team has already learned every operational quirk in lower-risk departments, so Phase 4 goes faster and cleaner.

  • Week 13: Diagnostic and imaging (~400 assets).
  • Week 14: Emergency (~250 assets; never goes offline, so tag during shift handovers).
  • Week 15: OT (4 theatres, ~500 assets; tag between scheduled cases).
  • Week 16: ICU and critical care (~400 assets; tag bed by bed during patient transfers).

By the end of Phase 4, the entire hospital is on the system. The first quarterly audit cycle runs in weeks 17-18 and validates the deployment. Once the register is live, integrations such as nurse call to asset lookup and IoT sensor feeds can be layered on without touching the tagging work.

Common Pitfalls To Avoid

  • Deploying ICU first. Guaranteed to fail. ICU staff are stretched, intolerant of disruption, and need the deployment to be already proven before they engage.
  • Skipping the asset register cleanup. Tagging on a dirty register propagates the existing data quality issues.
  • Insufficient biomedical training. The team must be the SMEs by Phase 2, not Phase 4.
  • Sharing the network with patient monitoring. RFID packet bursts affect QoS. Use a dedicated PoE switch.
  • Not running the walk test. Every reader must be validated with a 50-tag walk-through at every angle before sign-off.
  • Standard tags on metal equipment. Bare metal detunes a standard UHF tag. Specify on-metal tags for steel-bodied assets in Phase 1, not after the pilot fails.
  • No owner for exceptions. Assets that read at a portal they should not be at, or fail to read at all, need a named person and a daily queue from week 5.

Worked Example: A 1,000-Bed Hospital's Clean Deployment

Shown as a worked scenario for a 1,000-bed multi-specialty hospital deploying Assetly RFID on 6,200 assets. Plan: 16 weeks; actual: 18, the overrun coming from one antenna repositioning after the walk test. Pilot scan accuracy 99.1%. Departmental rollout completes without operational disruption to any clinical service. First audit cycle in week 19 reconciles at 99.6%, the highest rate in the hospital's history. The two things that made the difference were the register cleanup in Phase 1 and holding the line on the 98% pilot gate.

What It Costs

For a 500-bed hospital with about 3,000 assets, year-1 hybrid barcode + UHF RFID hardware runs ₹21-22 lakh ($26,000): printer, labels and tags, 4 portal readers, 2 handhelds, antennas, cabling, and middleware. Software is separate and annual. A 1,000-bed hospital with 6,000+ assets roughly doubles the tag and portal lines. Hospitals deploying Assetly typically see ₹35-80 lakh in year-1 savings from fewer duplicate purchases, right-sized AMCs, and audit staff-hours, which is why payback usually lands at 18-24 months. The line-item breakdown is in the RFID vs barcode cost section.

Resource Requirements For A 500-1,000 Bed Deployment

  • Internal team: 1 biomedical lead (dedicated), 2 biomedical engineers (50% time), 1 IT lead, 1 procurement lead.
  • External team: deployment partner (Assetly + integrator) for the full 16 weeks.
  • Time investment: roughly 320-480 internal hours over 16 weeks.

NABH: What The Deployment Has To Produce

For Indian hospitals, NABH assessors want an equipment inventory that reconciles to what is physically on the floor, with preventive maintenance and calibration records attached. The week 17-18 audit cycle is designed to produce exactly that.

Key Takeaways

  • A 16-week phased deployment is the operational standard for large hospitals.
  • Asset register cleanup must precede tagging. Don't tag a dirty register.
  • Pilot 100 assets in 2 low-risk departments before any wider rollout, and hold the 98% accuracy gate.
  • ICU and OT go last, not first. Deploy after all the operational quirks are learned.
  • The RFID network must be dedicated, not shared with patient monitoring.
  • Validate every reader with a 50-tag walk test.
  • Budget ₹21-22 lakh ($26,000) in year-1 hardware for a 500-bed hospital and 320-480 internal hours.

Planning An RFID Rollout In Your Hospital?

Read the complete guide to hospital asset management, or talk to the Assetly team for a deployment plan built around your department mix and asset count. Assetly goes live in 4-6 weeks with zero downtime and a dedicated implementation manager; start with a 30-day pilot in one department.

Ready to scale?

Talk to our healthcare engineering team about building, integrating, and shipping faster.

Frequently Asked Questions

How long does it take to implement RFID asset tracking in a large hospital?

16 weeks is the operational standard for a 500-1,000 bed hospital: 4 weeks of foundation work, a 4-week pilot, 4 weeks of department-by-department rollout, and 4 weeks for emergency, OT, and ICU. Expect 1-2 weeks of slippage if the walk test forces an antenna reposition.

Should ICU and OT be deployed first or last in a hospital RFID rollout?

Last, always. ICU and OT cannot tolerate disruption, and their staff need the system proven elsewhere before they engage. Deploy central stores and the biomedical workshop first, then general wards, and reach ICU and OT in weeks 14-16 once every operational quirk is known.

How much does hospital RFID asset tracking cost?

For a 500-bed hospital with about 3,000 assets, year-1 hybrid barcode + UHF RFID hardware runs ₹21-22 lakh ($26,000): printer-encoder, tags and labels, 4 portal readers, 2 handhelds, antennas, cabling, and middleware. Software is annual and separate. Payback typically lands at 18-24 months.

How many staff hours does a hospital invest in RFID deployment?

Roughly 320-480 internal hours over 16 weeks: a dedicated biomedical lead, two biomedical engineers at half time, an IT lead, and a procurement lead, with the deployment partner covering the rest.

Which hospital equipment gets RFID tags?

Mobile biomedical equipment (infusion pumps, monitors, wheelchairs), high-value fixed equipment for audit, OT instrument trays with autoclavable tags, linen and consumables with laundry-grade or passive tags, and IT assets. Stationary equipment usually stays on barcode.
Share
