Nirmitee.io
Healthcare

ML Model Lifecycle in Healthcare: From Jupyter Notebook to ICU Bedside

April 17, 202612 min readUpdated Sep 26, 2026
Written by
Jitendra Choudhary
Jitendra Choudhary

CTO & Co-Founder

CTO & Co-Founder at Nirmitee.io. Architects healthcare integrations across FHIR, SMART on FHIR, ABDM and NHCX, writing from production experience taking hospital software from sandbox to go-live.

ML Model Lifecycle in Healthcare: From Jupyter Notebook to ICU Bedside

There is a well-known statistic in machine learning: 87% of models never make it to production. In healthcare, the number is even worse. A 2025 JMIR scoping review found that fewer than 15% of clinical ML models published in peer-reviewed literature are ever deployed in clinical settings. The gap between a promising Jupyter notebook and a model running at an ICU bedside is not a gap of engineering skill — it is a gap of process, governance, and operational maturity.

This article maps the complete lifecycle of a healthcare ML model across seven stages, from initial exploration to eventual retirement. At each stage, we will cover what happens, who is involved, what the healthcare-specific requirements are, and what typically goes wrong. Whether you are building a sepsis early warning system, a radiology triage model, or a readmission predictor, this lifecycle applies to every clinical ML project. For a foundational understanding of what MLOps is and why healthcare needs it, start with our introduction to MLOps for healthcare developers.

For hands-on help with this, see our healthcare AI services.

Stage 1: Exploration — The Notebook Phase

Every clinical model begins in a Jupyter notebook. This is the exploratory data analysis (EDA) phase where data scientists load clinical datasets, examine distributions, identify patterns, and test whether a predictive signal exists.

What Happens

  • Load de-identified clinical data from your data warehouse or FHIR server
  • Perform exploratory data analysis — distributions, correlations, missing data patterns
  • Test basic models (logistic regression, random forest) to establish whether a predictive signal exists
  • Identify feature candidates and data quality issues
  • Document initial findings and define the prediction task clearly

Healthcare-Specific Considerations

Data access requires IRB approval or a de-identification certification. Even in the exploration phase, you must work within a HIPAA-compliant environment — no clinical data on personal laptops, no screenshots of patient records in Slack. Data quality in healthcare is notoriously inconsistent: EHR data has systemic missingness (nurses chart differently by shift, weekends have fewer labs), temporal biases (admission patterns differ by day of week), and coding variations across departments.

# Stage 1: Exploration - Initial EDA for sepsis prediction
import pandas as pd
import matplotlib.pyplot as plt

# Load de-identified clinical data
df = pd.read_parquet("deidentified_icu_stays_2024.parquet")

# Basic data quality assessment
print(f"Total ICU stays: {len(df):,}")
print(f"Sepsis cases: {df['sepsis_label'].sum():,} ({df['sepsis_label'].mean()*100:.1f}%)")
print(f"\nMissing data rates:")
for col in ['heart_rate', 'sbp', 'temperature', 'wbc', 'lactate', 'creatinine']:
    missing = df[col].isna().mean() * 100
    print(f"  {col}: {missing:.1f}%")

# Check for temporal leakage
print(f"\nDate range: {df['admission_date'].min()} to {df['admission_date'].max()}")
print(f"Weekend admissions: {df['is_weekend'].mean()*100:.1f}%")

# Baseline model to check if signal exists
from sklearn.linear_model import LogisticRegression
from sklearn.model_selection import cross_val_score

features = ['heart_rate', 'sbp', 'temperature', 'wbc', 'age']
X = df[features].fillna(df[features].median())
y = df['sepsis_label']

baseline_auc = cross_val_score(
    LogisticRegression(), X, y, cv=5, scoring='roc_auc'
).mean()
print(f"\nBaseline logistic regression AUC: {baseline_auc:.3f}")

Stage 1 Checklist

ItemStatusNotes
IRB approval or de-identification certificationRequiredBefore any data access
Data loaded in a HIPAA-compliant environmentRequiredNo local laptops
Missing data analysis completedRequiredDocument rates per feature
Temporal leakage checkRequiredNo future data in features
Baseline model confirms predictive signalRequiredAUC greater than 0.60 to proceed
The prediction task is clearly definedRequiredTarget, time horizon, population

Estimated duration: 2-4 weeks

Stage 2: Experimentation — Tracked Iterations

Once you have confirmed that a predictive signal exists, experimentation begins in earnest. This is the most iterative stage — dozens or hundreds of runs testing different feature sets, model architectures, hyperparameters, and preprocessing strategies.

What Happens

  • Systematic hyperparameter search (grid search, Bayesian optimization)
  • Feature engineering and selection experiments
  • Model architecture comparison (gradient boosting vs. neural networks vs. ensemble)
  • Every run tracked with MLflow: parameters, metrics, artifacts, and data version
  • Cross-validation with clinically meaningful metrics (sensitivity at fixed specificity, calibration)
# Stage 2: Experimentation - MLflow tracked hyperparameter search
import mlflow
import optuna
from sklearn.ensemble import GradientBoostingClassifier
from sklearn.metrics import roc_auc_score

mlflow.set_experiment("sepsis-prediction-v2-experiments")

def objective(trial):
    with mlflow.start_run(run_name=f"optuna-trial-{trial.number}"):
        params = {
            "n_estimators": trial.suggest_int("n_estimators", 100, 500),
            "max_depth": trial.suggest_int("max_depth", 3, 10),
            "learning_rate": trial.suggest_float("learning_rate", 0.01, 0.3),
            "subsample": trial.suggest_float("subsample", 0.6, 1.0),
            "min_samples_leaf": trial.suggest_int("min_samples_leaf", 5, 50),
        }
        mlflow.log_params(params)
        mlflow.log_param("data_version", "v2.3")
        mlflow.log_param("feature_set", "vitals+labs+demographics")

        model = GradientBoostingClassifier(**params, random_state=42)
        model.fit(X_train, y_train)

        y_pred = model.predict_proba(X_val)[:, 1]
        auc = roc_auc_score(y_val, y_pred)

        mlflow.log_metric("val_auc", auc)
        mlflow.log_metric("trial_number", trial.number)

        return auc

study = optuna.create_study(direction="maximize")
study.optimize(objective, n_trials=100)

print(f"Best AUC: {study.best_value:.4f}")
print(f"Best params: {study.best_params}")

Critical rule: Never log patient identifiers as experiment parameters. Log data version IDs, feature set names, and aggregate statistics — never individual patient records.

Estimated duration: 4-8 weeks

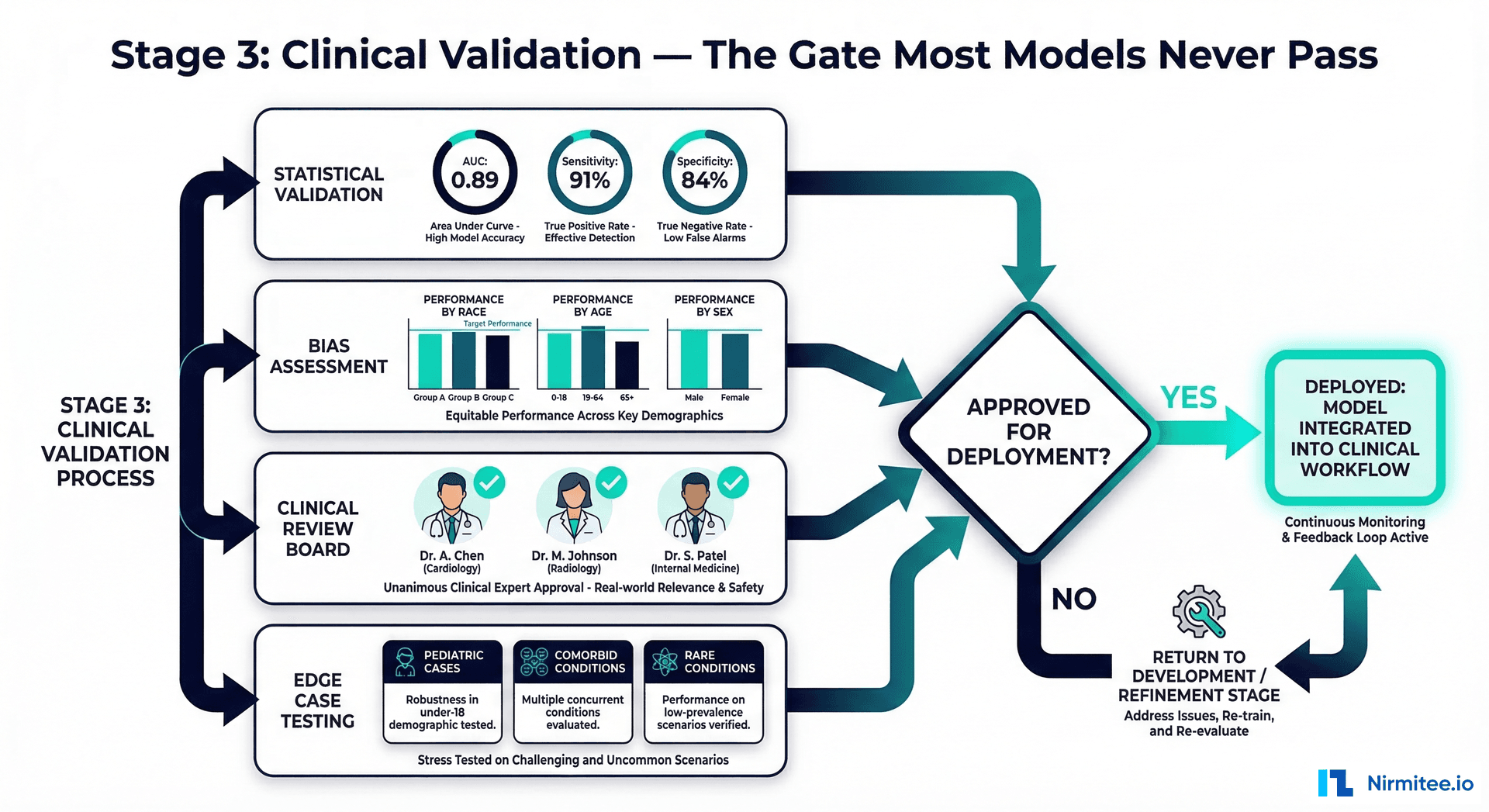

Stage 3: Validation — The Gate Most Models Never Pass

Validation in healthcare is fundamentally different from validation in other industries. In e-commerce, if your recommendation model's accuracy drops by 5%, revenue dips slightly. In healthcare, a 5% accuracy drop in a sepsis model means patients who should have been flagged are being missed. Clinical validation is where most healthcare ML projects die — not because the model is bad, but because the validation process is rigorous, time-consuming, and involves stakeholders outside the engineering team.

Four Validation Tracks

Track 1: Statistical Validation

  • AUC-ROC on held-out test set (never used during training or hyperparameter tuning)
  • Sensitivity and specificity at clinically meaningful thresholds
  • Calibration curves — does a 70% predicted probability actually mean 70% chance?
  • Confidence intervals via bootstrapping
  • Comparison against existing clinical scoring systems (qSOFA, MEWS, NEWS)

Track 2: Fairness and Bias Assessment

  • Stratified performance by race, ethnicity, sex, age group, and insurance status
  • Disparate impact analysis — does the model systematically under-flag certain populations?
  • Subgroup analysis on known vulnerable populations

Track 3: Clinical Review Board

  • Clinicians (typically the CMIO, clinical informaticists, and domain physicians) review model predictions on sample cases
  • Case-by-case evaluation: "Would this alert have been clinically useful?"
  • False positive analysis: "Would this alert cause alarm fatigue?"
  • Integration assessment: "How does this fit into existing clinical workflows?"

Track 4: Edge Case Testing

  • Performance on pediatric patients (if model trained primarily on adults)
  • Performance on patients with multiple comorbidities
  • Performance on rare conditions related to the prediction target
  • Behavior on out-of-distribution inputs (what happens with missing data?)

Estimated duration: 4-12 weeks (often the bottleneck of the entire lifecycle)

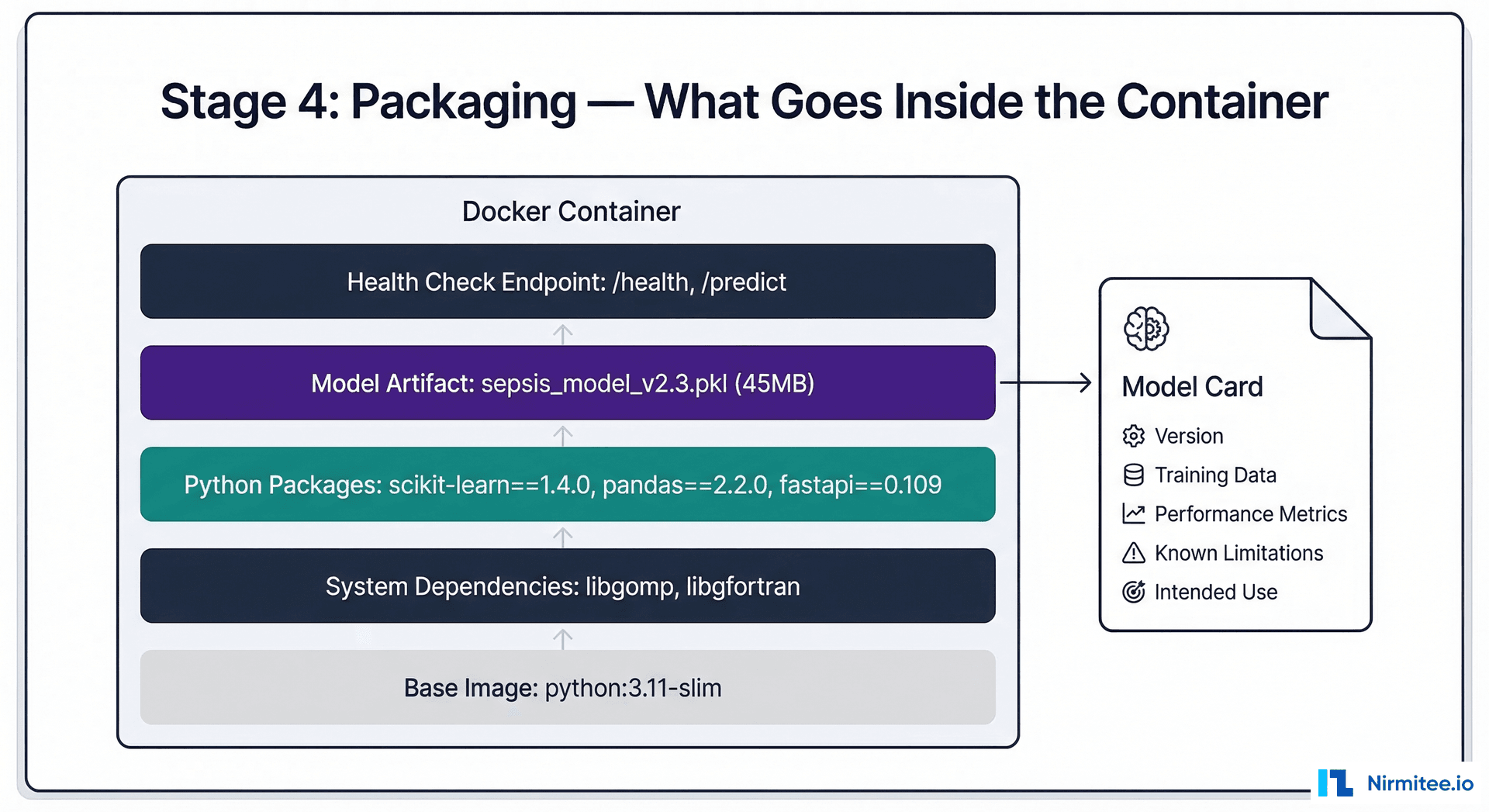

Stage 4: Packaging — Making the Model Deployable

A validated model in a Jupyter notebook is not deployable. Packaging transforms the model into a production-ready artifact that can be deployed consistently across environments.

What Gets Packaged

  • Model artifact: The trained model file (ONNX, SavedModel, or serialized format)
  • Dependencies: Exact pinned versions of every library (requirements.txt with ==, not >=)
  • Preprocessing code: Feature transformation pipeline that matches training exactly
  • Serving code: FastAPI/Flask endpoint that accepts input and returns predictions
  • Health check endpoints: /health (is the container running?), /ready (is the model loaded?)
  • Model card: Documentation of training data, performance, limitations, intended use
# Dockerfile for clinical ML model
FROM python:3.11-slim

# System dependencies for scikit-learn
RUN apt-get update && apt-get install -y --no-install-recommends \
    libgomp1 \
    && rm -rf /var/lib/apt/lists/*

WORKDIR /app

# Install exact pinned dependencies
COPY requirements.txt .
RUN pip install --no-cache-dir -r requirements.txt

# Copy model and serving code
COPY model/ ./model/
COPY serve.py .
COPY preprocessing.py .
COPY model_card.json .

# Non-root user for security
RUN useradd -m appuser && chown -R appuser:appuser /app
USER appuser

# Health check
HEALTHCHECK --interval=30s --timeout=10s --retries=3 \
    CMD curl -f http://localhost:8080/health || exit 1

EXPOSE 8080
CMD ["uvicorn", "serve:app", "--host", "0.0.0.0", "--port", "8080"]
# serve.py - FastAPI model serving endpoint
from fastapi import FastAPI, HTTPException
from pydantic import BaseModel
import joblib
import numpy as np
from preprocessing import preprocess_features

app = FastAPI(title="Sepsis Prediction Model v2.3")
model = joblib.load("model/sepsis_model_v2.3.joblib")

class PredictionRequest(BaseModel):
    heart_rate: float
    sbp: float
    temperature: float
    wbc: float = None
    lactate: float = None
    creatinine: float = None
    age: int

class PredictionResponse(BaseModel):
    risk_score: float
    risk_level: str
    model_version: str = "2.3"

@app.get("/health")
def health():
    return {"status": "healthy", "model_loaded": model is not None}

@app.get("/ready")
def ready():
    # Test prediction to verify model can serve
    test_input = np.zeros((1, 7))
    try:
        model.predict_proba(test_input)
        return {"status": "ready"}
    except Exception as e:
        raise HTTPException(status_code=503, detail=str(e))

@app.post("/predict", response_model=PredictionResponse)
def predict(req: PredictionRequest):
    features = preprocess_features(req.dict())
    proba = model.predict_proba(features.reshape(1, -1))[0][1]

    risk_level = "LOW" if proba < 0.3 else "MEDIUM" if proba < 0.7 else "HIGH"
    return PredictionResponse(risk_score=round(proba, 4), risk_level=risk_level)

Estimated duration: 1-2 weeks

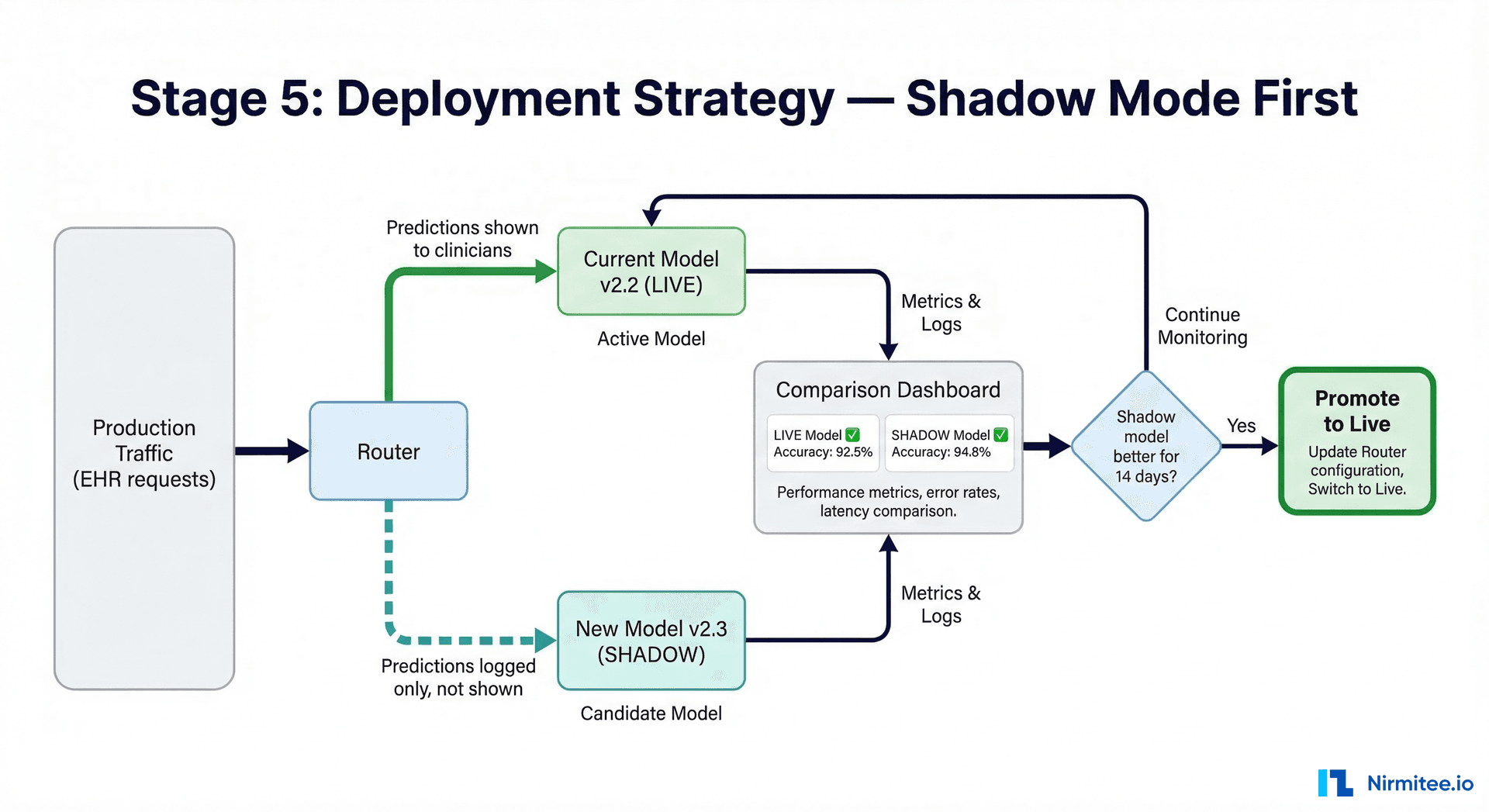

Stage 5: Deployment — Shadow Mode First, Always

In healthcare, you never deploy a model directly to production. The standard practice is shadow deployment: the new model receives real production data and makes predictions, but those predictions are logged — not shown to clinicians. This allows you to compare the new model's predictions against ground truth and the existing model (or existing clinical workflow) before going live.

# Kubernetes deployment with shadow mode
apiVersion: apps/v1
kind: Deployment
metadata:
  name: sepsis-model-shadow
  labels:
    app: sepsis-prediction
    mode: shadow
spec:
  replicas: 2
  selector:
    matchLabels:
      app: sepsis-prediction
      mode: shadow
  template:
    metadata:
      labels:
        app: sepsis-prediction
        mode: shadow
    spec:
      containers:
      - name: model
        image: registry.internal/sepsis-model:v2.3-shadow
        ports:
        - containerPort: 8080
        resources:
          requests:
            cpu: "500m"
            memory: "1Gi"
          limits:
            cpu: "1000m"
            memory: "2Gi"
        livenessProbe:
          httpGet:
            path: /health
            port: 8080
          initialDelaySeconds: 30
          periodSeconds: 10
        readinessProbe:
          httpGet:
            path: /ready
            port: 8080
          initialDelaySeconds: 45
          periodSeconds: 10
        env:
        - name: MODEL_MODE
          value: "shadow"  # Predictions logged, not served to clinicians
        - name: METRICS_ENDPOINT
          value: "http://monitoring:9090/push"

Shadow mode typically runs for 2-4 weeks. During this period, you compare the shadow model's predictions against both the existing model and actual clinical outcomes. Only after this validation period — and with clinical review board approval — does the model go live. For more on Kubernetes deployment patterns for healthcare models, see our upcoming guide on Docker and Kubernetes for healthcare ML.

Estimated duration: 2-4 weeks in shadow mode before promotion

Stage 6: Monitoring — The Stage Nobody Plans For

Monitoring is where the MLOps lifecycle diverges most dramatically from traditional DevOps. In DevOps, monitoring means uptime, latency, and error rates. In MLOps, you must monitor accuracy, data drift, concept drift, fairness metrics, and prediction distribution — on top of the standard infrastructure metrics.

What to Monitor

Metric CategoryWhat to TrackAlert Threshold
Model PerformanceAUC-ROC, sensitivity, specificity (against ground truth)AUC drops below 0.85
Data DriftDistribution shift in input features vs. training dataDrift score greater than 0.3
Concept DriftThe relationship between features and outcomes has changedCalibration error greater than 0.1
Prediction DistributionDistribution of output scores vs. historical baselineGreater than 20% shift in mean prediction
FairnessPerformance stratified by demographicsDisparity ratio greater than 1.25
InfrastructureLatency, throughput, error rate, and memory usageP99 latency greater than 500ms
# Automated monitoring check (runs daily via cron)
from evidently.report import Report
from evidently.metric_preset import DataDriftPreset
import smtplib
from email.mime.text import MIMEText

def daily_drift_check(training_data, production_data, alert_email):
    report = Report(metrics=[DataDriftPreset()])
    report.run(reference_data=training_data, current_data=production_data)

    result = report.as_dict()
    drift_detected = result["metrics"][0]["result"]["dataset_drift"]
    drift_share = result["metrics"][0]["result"]["drift_share"]

    if drift_detected:
        msg = MIMEText(
            f"DATA DRIFT ALERT - Sepsis Model v2.3\n\n"
            f"Drift detected in {drift_share*100:.0f}% of features.\n"
            f"Immediate review required. Check monitoring dashboard.\n"
            f"Consider initiating retraining pipeline."
        )
        msg["Subject"] = "[CRITICAL] Sepsis Model Data Drift Detected"
        msg["To"] = alert_email
        # Send alert to clinical informatics team
        send_alert(msg)

    return {"drift_detected": drift_detected, "drift_share": drift_share}

For a non-technical explanation of why models degrade and what clinical leaders should ask their AI vendors, see our companion article on model drift for healthcare teams. For comprehensive observability tooling, see our guide on observability dashboards for healthcare AI.

Duration: Continuous, for the lifetime of the model in production

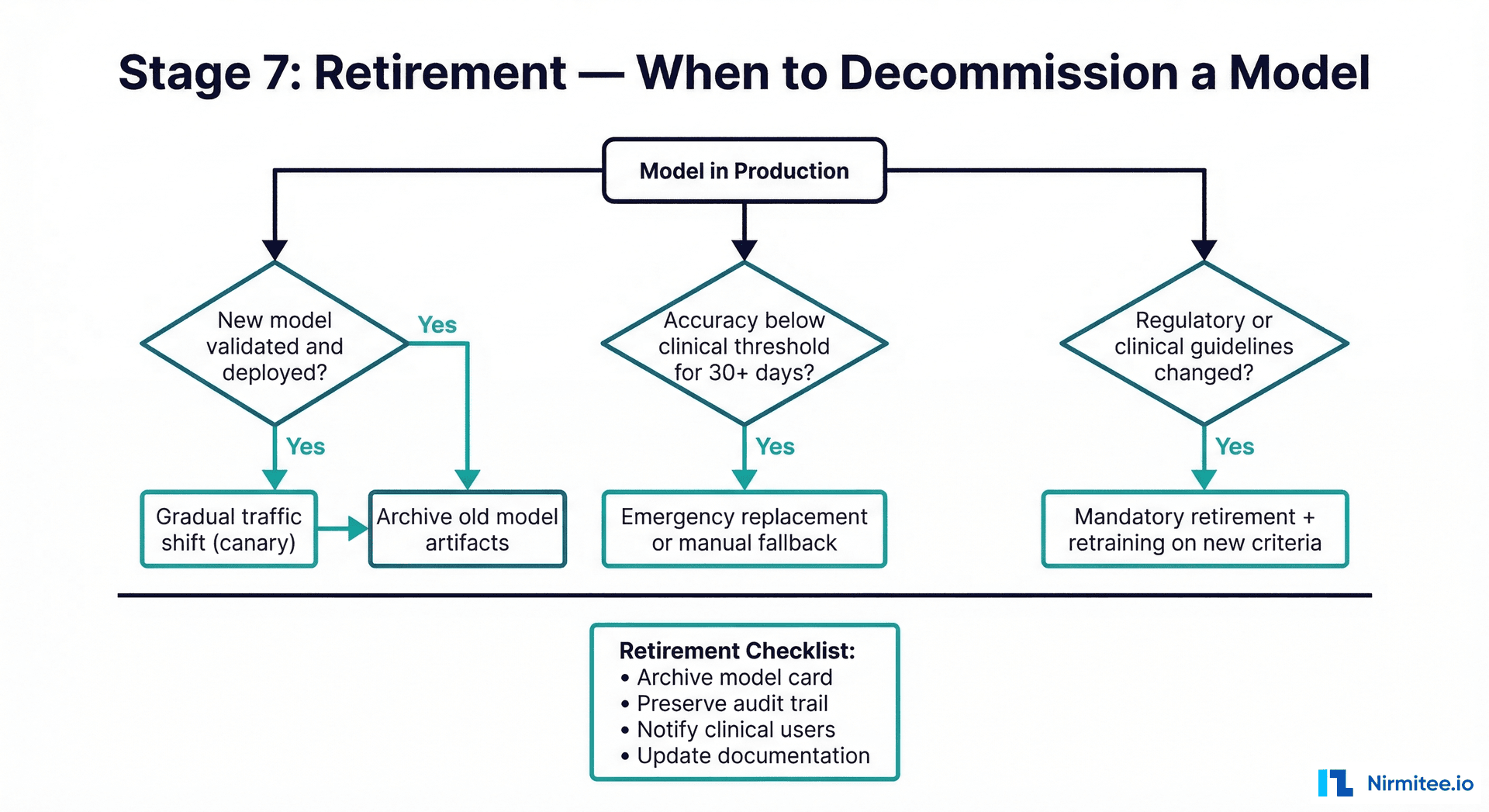

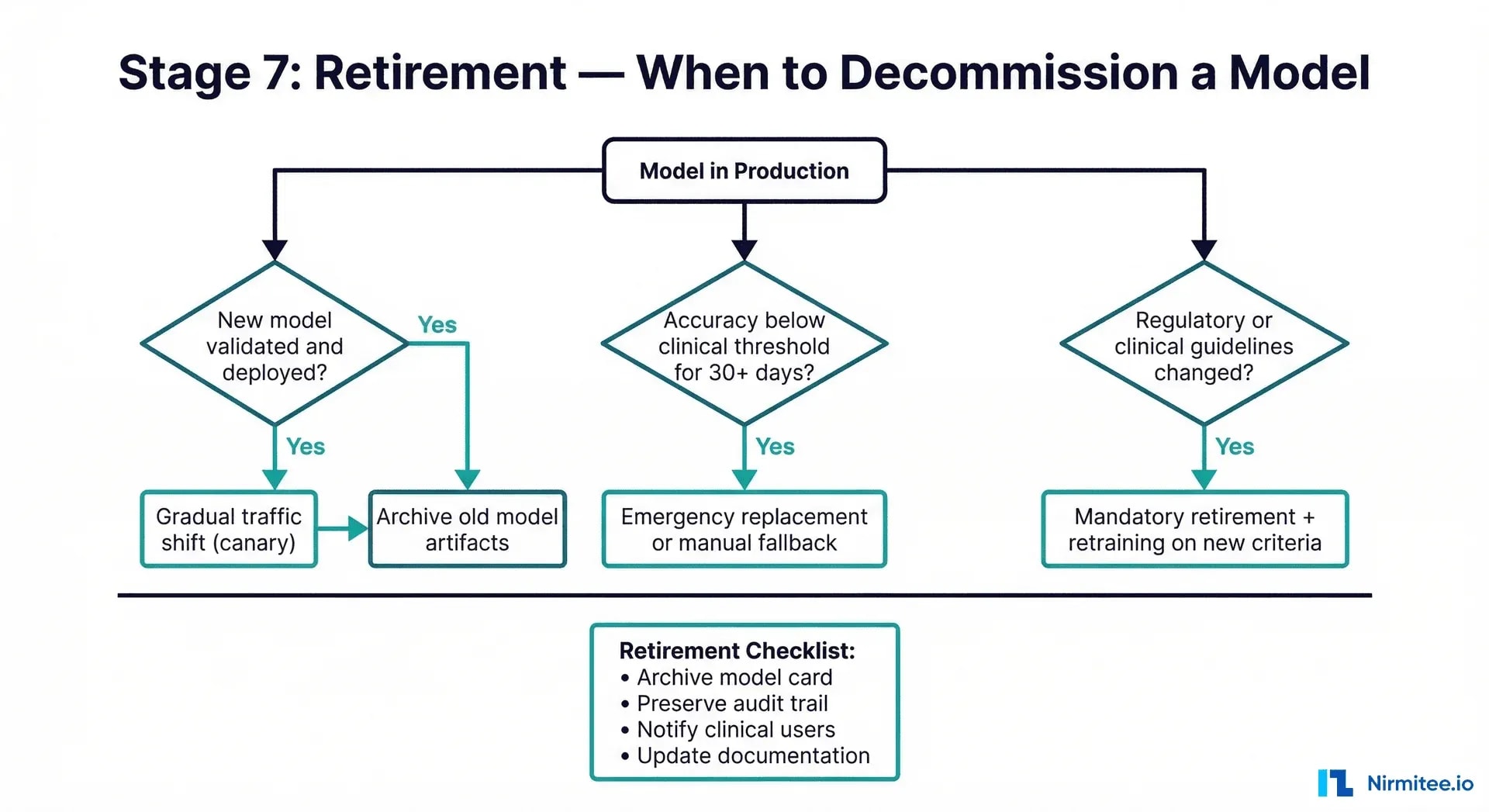

Stage 7: Retirement — Knowing When to Stop

Every model has a lifespan. Retirement is the least documented but critically important final stage. A model should be retired when:

  • A better model replaces it — the new model has been validated and shadow-tested
  • The clinical context has changed — new guidelines, new treatment protocols, new patient population
  • Accuracy has degraded beyond recovery — retraining does not restore performance to clinical thresholds
  • Regulatory requirements have changed — the model no longer meets updated compliance standards

Retirement Checklist

  • Archive all model artifacts, training data references, and experiment logs
  • Preserve the complete audit trail for regulatory retention requirements
  • Notify all clinical users and downstream systems
  • Update clinical workflow documentation
  • If FDA-regulated: file updated documentation with the agency
  • Retain model card and performance history for future reference

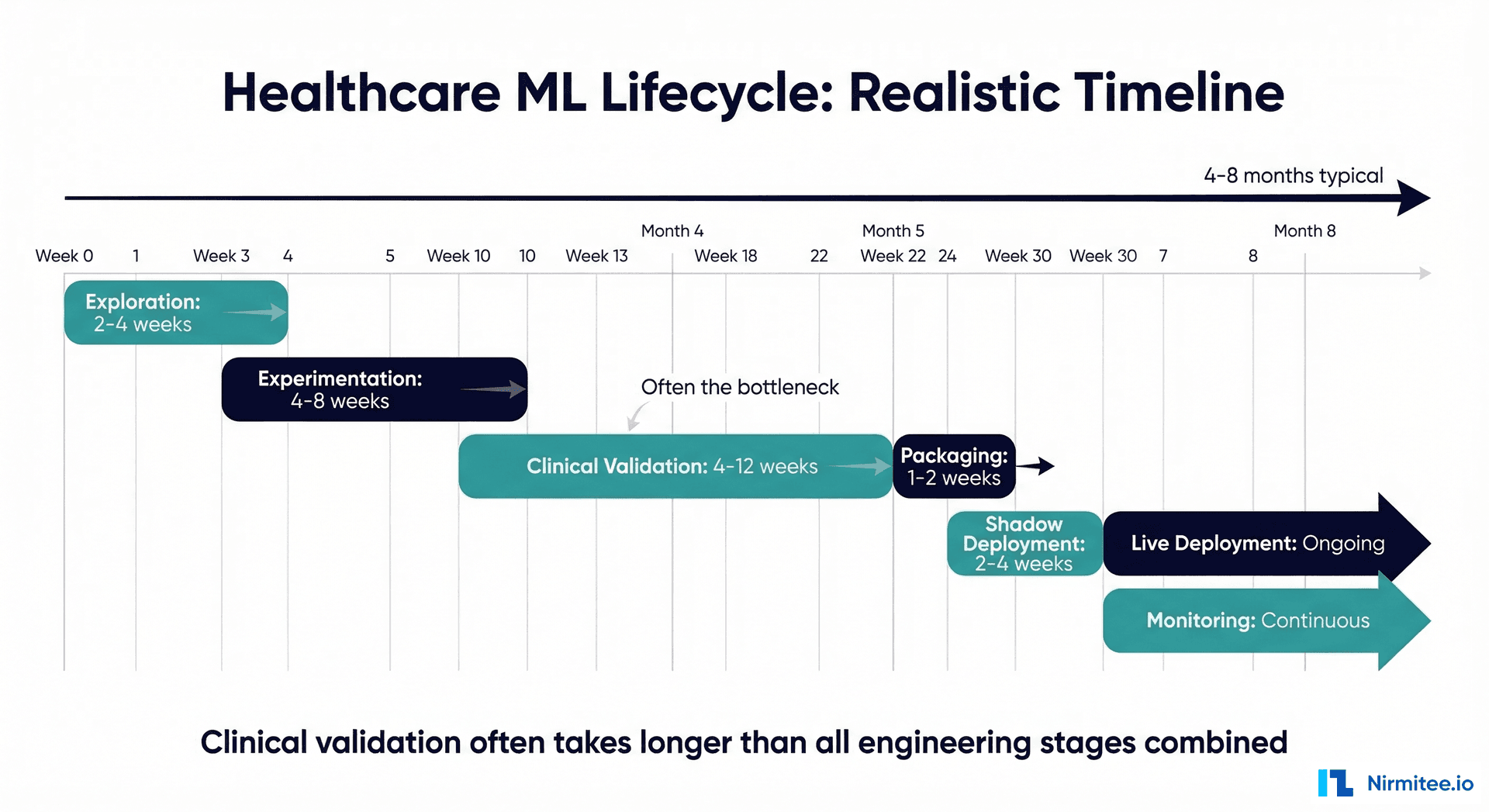

Realistic Timeline: What to Expect

StageTypical DurationKey Bottleneck
1. Exploration2-4 weeksData access and IRB approval
2. Experimentation4-8 weeksCompute resources and iteration speed
3. Clinical Validation4-12 weeksClinical review board scheduling and feedback cycles
4. Packaging1-2 weeksDependency management and security scanning
5. Shadow Deployment2-4 weeksAccumulating enough production data for comparison
6. MonitoringContinuousDefining meaningful thresholds
7. Retirement1-2 weeksStakeholder communication

Total time to first production deployment: 4-8 months. The most common surprise for engineering teams is that clinical validation (Stage 3) often takes longer than all engineering stages combined. Planning for this from the start prevents frustration and missed deadlines.

Ready to scale?

Talk to our healthcare engineering team about building, integrating, and shipping faster.

Frequently Asked Questions

What is the ML model lifecycle in healthcare?

The healthcare ML model lifecycle spans seven stages, from exploration in a Jupyter notebook through experimentation, validation, and deployment to eventual retirement, with healthcare-specific requirements at every stage. Whether the project is a sepsis early warning system, a radiology triage model, or a readmission predictor, the same lifecycle applies, and the gap between notebook and ICU bedside is one of process, governance, and operational maturity rather than engineering skill.

Why do so few clinical ML models reach production?

Fewer than 15% of clinical ML models published in peer-reviewed literature are ever deployed in clinical settings, according to a 2025 JMIR scoping review, worse than the well-known 87% failure rate across machine learning generally. The blockers are rarely technical: clinical validation is the gate most models never pass, because in healthcare a 5% accuracy drop means patients who should have been flagged, such as sepsis cases, are being missed.

What is required before exploring clinical data for machine learning?

Before any data access you need IRB approval or a de-identification certification, and all work must happen in a HIPAA-compliant environment, meaning no clinical data on personal laptops and no screenshots of patient records in chat tools. The exploration-phase checklist also requires a missing data analysis, a temporal leakage check ensuring no future data in features, a clearly defined prediction task, and a baseline model AUC above 0.60 before proceeding.

How should healthcare teams track ML experiments?

Track every experimentation run with a tool like MLflow, logging parameters, metrics, artifacts, and the data version, so dozens or hundreds of hyperparameter and feature-set trials remain reproducible. Use clinically meaningful evaluation such as sensitivity at fixed specificity and calibration, not just AUC. One critical rule: never log patient identifiers as experiment parameters; log data version IDs, feature set names, and aggregate statistics only.

Why is EHR data quality a problem for clinical ML models?

EHR data carries systemic quality issues that bias models: missingness is not random because nurses chart differently by shift and weekends have fewer labs, admission patterns differ by day of week creating temporal biases, and coding varies across departments. That is why the exploration stage requires documenting missing data rates per feature and checking for temporal leakage before trusting any predictive signal found in the data.

How does Nirmitee.io approach healthcare software development?

Nirmitee.io follows a healthcare-first engineering approach — every solution is built with HIPAA compliance, HL7/FHIR interoperability standards, and clinical workflow requirements at the core. We combine domain expertise with modern engineering practices to deliver production-ready systems.
Share
